Every assumption a PM makes before fabrication is a field problem that has not happened yet.

None of these are careless. Each one is a reasonable guess made by a busy PM with eleven other things open, and each one is right often enough to feel safe. Here are the five that cost the most when they are wrong, what you would actually watch happen, and what to check instead.

1. “The rough opening is probably right.” (It is not.)

The design dimension on the approved drawing says 8 feet 0 inches. The block mason was allowed a tolerance, the slab poured a little high at one corner, and the opening is 7 feet 11-1/4 at the sill and 8 feet 0-1/2 at the head. The frame built to 8 feet 0 does not go in. The crew either cuts it down on a jobsite saw, sends it back, or waits for a remake, and each of those costs more than the field measurement would have.

Check instead: a field dimension at three heights, plumb on both jambs, and level on the sill, or a guaranteed opening size from the GC in writing, before the release goes out. A drawing with “VIF” still on it is not released. When the opening does not match, the rough opening article walks through modify, send back, or remake.

2. “Hardware power supply routing is someone else’s concern.”

The door has a card reader and an electric strike on the schedule. The PM assumes the electrician will get power to it, the electrician assumes the glazier will leave a path in the frame, and the shop assumes nobody said anything because nothing is electrified. The frame arrives finished, with no path from the header to the strike, and someone drills through dark bronze anodize on the jobsite to run a wire that should have gone through bare extrusion in the shop.

Check instead: confirm every electrified device with the hardware supplier before release, and put the wire path on the drawings so the shop preps it before finish. The electrified door hardware article covers the path from the supply to the device, and the entrance release article covers the other five door details that change the prep.

3. “The field can make it work.”

The frame is 3/8 narrow, the crew has a chop saw, and the foreman says he can take it out of the sill. He can, but cutting only the sill leaves the frame out of square, the finished sill face picks up a scratch in the handling, and the door jamb that was prepped for pivots at a specific height is now 3/8 off the threshold it was prepped for. The field fix created two more field fixes and a finish claim.

Check instead: before any field modification, ask whether the cut moves a hardware prep or a pivot; whether the frame stays square; whether the cut edge will show; and whether the crew would be freehanding something the shop does on a machine. If any answer is yes, the fix belongs in the shop. Field modification is right when the cut is simple and the edge is hidden, and wrong the rest of the time.

4. “The finish is close enough.”

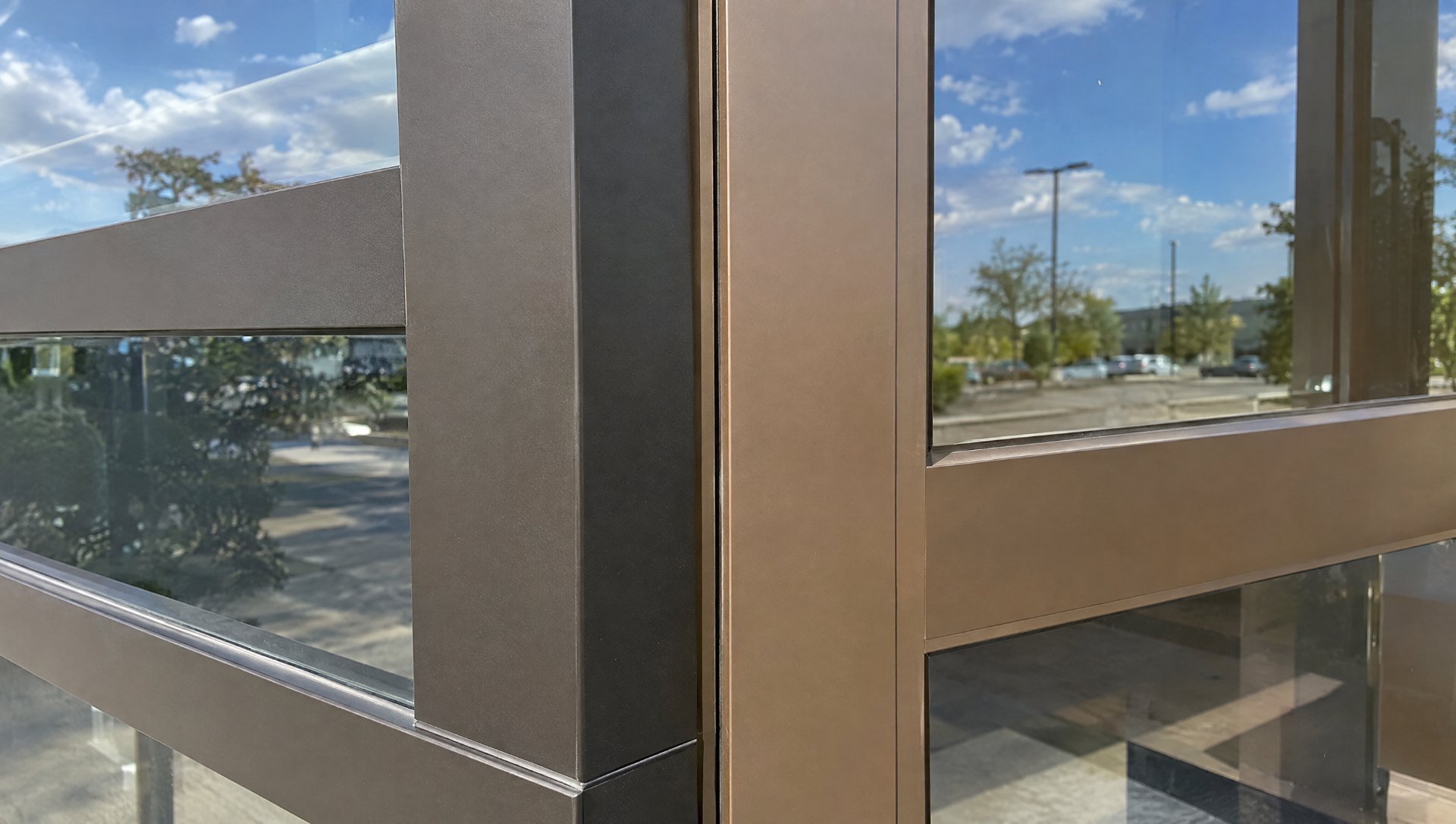

Dark bronze anodized storefront frame next to a bronze painted door stile with a visible color mismatch, the finish is close enough assumption a PM makes before fabrication
“Close enough” in the shop is two colors at the entrance in afternoon light. (Illustration)

The spec says dark bronze anodized. The storefront framing comes from Tubelite in dark bronze anodized, and the break metal flashing comes from an aluminum supplier, also called dark bronze anodized. Side by side at the head in afternoon light, they are two different colors, and the architect sees it on the walk-through. The same thing happens when a job is specified black anodized and dark bronze flashing gets ordered because it is in stock and close enough. Nothing goes back to the finisher. The flashing gets re-ordered in the right finish, and the opening waits for it.

Check instead: every component on the job is ordered in the specified finish, including break metal and flashing that come from a different supplier than the framing. When two suppliers are involved, somebody compares a sample of each side by side before the order goes in. Once the finish is on and gets hit in shipping or on site, the scratch repair article covers what can and cannot be fixed.

5. “The fabricator will figure it out.”

What gets left to the fabricator is whatever nobody wrote down. The expensive one is hardware: nobody stopped to check whether the hardware specified actually fits the doors that were ordered. The rest are installer preferences the shop cannot guess, like frames shipped preassembled or horizontals notched for roll-in pieces. When those are missing, the shop does one of two things: stops and asks, which costs a week of back-and-forth while the package sits, or decides, which is a remake waiting to happen when the decision was not the one the PM would have made. Neither is the fabricator’s fault. The release handed him a guess.

Check instead: list what is missing, in writing, and send it with the release as open items, or hold the affected openings until it is closed. The fabrication release article lays out what a complete release contains, document by document, and the five-item checklist is the one-minute version.

RESOURCE: Five-panel detail sheet, one panel per assumption: the opening measured versus drawn; the wire path missing from the frame; a frame cut out of square in the field; dark bronze anodized framing next to “dark bronze” break metal flashing from a different supplier; a specified hardware device that does not fit the door that was ordered. Marcus to assign a drafter. Drawing: MP Drafting and Design for WestMetal Fabrication.

The takeaway

Every assumption made before fabrication becomes a potential field problem, so verify the details that are hardest and most expensive to correct later: the opening, the power, the modification, the finish, and the missing information. Each one takes minutes to check before release and weeks to fix after.

WestMetal Fabrication reads every release for the assumption in it before cutting, and asks once, in one list, rather than guessing. See what WestMetal fabricates.

Talk to WestMetal

Learn the fundamentals on LearnGlazing

Two free LearnGlazing courses cover the ground this article skips. Introduction to Fabrication walks through shop operations and delivery considerations, and Introduction to Door Hardware explains knocked-down, shop-assembled, and pre-glazed packaging. WestMetal Group is a LearnGlazing partner through the GlazierIQ network. Browse the full course catalog.

Bob, WestMetal Group

Bob Baumann
Sales, WestMetal Group

I have been on the fabrication side of glazing for a long time, and before WestMetal I ran a shop floor where the release was the thing that decided whether the week went well or badly. I still read every package that comes in before it goes to the saw, and I still call the PM when something on it does not add up. WestMetal Group is part of the GlazierIQ network with MP Drafting and LearnGlazing. Questions about an article or a package? Send it to Bob.

</div >
